A production line almost never goes down over something expensive. It goes down over a two-dollar fastener nobody reordered, or a pallet of resin that sat in customs for four extra days. The presses were fine. The operators were on shift. The material was not there.

That is the daily reality of procurement in manufacturing, and it is why buying inside a factory works nothing like buying in an office. You are not filling a shelf. You are feeding a schedule that has already been promised to a customer.

This guide covers what manufacturing procurement actually involves, how the process runs from requirement to payment, where it usually falls apart, and seven practical steps to tighten it up — without burying your buyers in another layer of paperwork. If you are earlier in the journey and want the fundamentals first, start with our guide to what procurement is and come back here.

What Is Procurement in Manufacturing?

Procurement in manufacturing is the process of planning, sourcing, buying, receiving and paying for the raw materials, components and services a plant needs to build its products. It covers everything from the steel that becomes the part to the calibration service that keeps the gauge honest.

The difference from other industries comes down to dependency. A retailer buys a finished product and puts it on a shelf; if one SKU arrives late, the rest of the store still trades. A manufacturer buys ingredients. If one specialised screw, one grade of steel or one calibrated sensor is missing, the finished unit cannot ship at all. Every purchase order sits on the critical path of a build.

Demand is also calculated rather than estimated. The bill of materials tells you how many of each part a unit consumes. The production schedule tells you how many units you are building. The MRP run turns that into requirements with dates attached. Procurement’s job is to make those dates land, at the right price and the right quality. That is also why buying in a plant is a strategic function rather than a clerical one — a distinction we unpack in procurement vs purchasing.

Direct and Indirect: The Two Halves of a Plant’s Spend

Almost everything a manufacturer buys falls into one of two buckets, and they need to be handled differently.

Direct materials go into the product: steel coil, resin, castings, PCBs, wiring harnesses, fasteners, primary packaging. This spend moves with production volume, lands in cost of goods sold, and usually runs on contracts and delivery schedules rather than one-off orders. Getting direct procurement right protects both margin and the build schedule.

Indirect materials keep the plant running: cutting fluid, gloves and safety gear, perishable tooling, spare motors, freight, calibration and maintenance services, IT. Any single indirect procurement order looks trivial. Added up across a year, it is usually where uncontrolled spend hides.

A car plant buying steel and rubber is direct. That same plant buying press lubricant and hi-vis vests is indirect. The split matters because the two need different controls — direct wants forecasting, contracts and supplier development; indirect wants catalogues, spend limits and as little manual handling as possible.

If your team argues about which category something belongs in, our breakdown of direct vs indirect procurement settles it, and operational procurement explains how the day-to-day buying cycle sits underneath both.

How the Procurement Process Works in a Manufacturing Plant

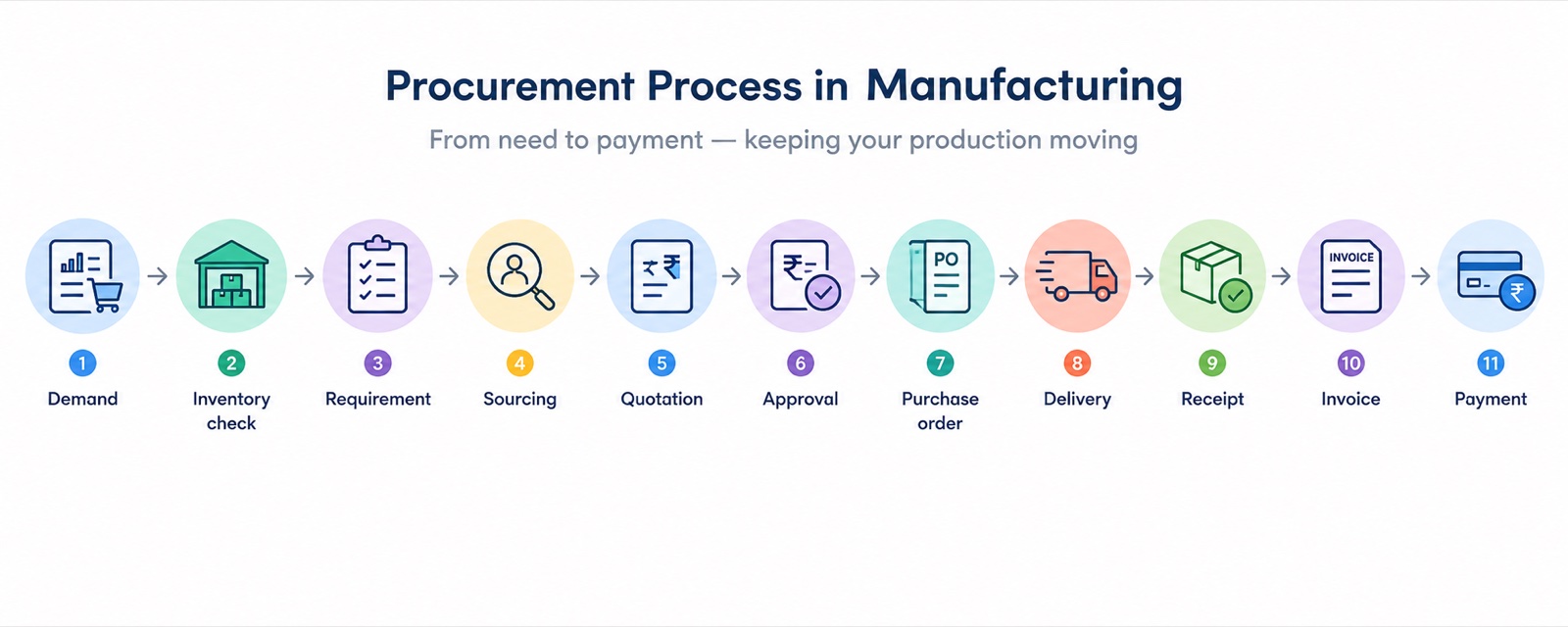

In a well-run plant the cycle follows a predictable path. Each stage exists because the one before it can go wrong.

  1. Requirement planning. MRP explodes the bill of materials against the production schedule. The buyer nets that off on-hand stock, open purchase orders and safety stock to work out what actually needs ordering, and by when. Accurate stock data is the whole foundation here, which is why inventory management in procurement and buying decisions cannot be separated.
  2. Sourcing and supplier selection. You compare vendors on landed cost, quality history, capacity, lead time and tooling ownership — not just unit price. For repeat direct materials this happens once and gets locked into a contract; for new parts it means an RFQ round and a sample approval. Our guide to sourcing optimization covers how to run that comparison properly, and procurement methods explains when to tender, negotiate or buy direct.
  3. Requisition and approval. Someone on the floor raises a request; someone with budget authority approves it. This is the stage that quietly eats days when it runs on email. A defined procurement workflow with routing rules fixes it. If the terminology trips people up, see purchase requisition vs purchase order.
  4. Purchase order issue. The approved request becomes a purchase order carrying quantity, price, delivery date, incoterms and quality requirements. It is a contract, not a note. The full sequence is laid out in our purchase order process guide, and purchase order tracking covers keeping visibility on it after it leaves.
  5. Receiving and inspection. Goods arrive at the dock, get counted against the PO, and go through incoming quality checks before they are released to production. The document that records this is the goods received note, and it is the single most useful piece of paper in a dispute with a supplier.
  6. Three-way match and payment. The invoice is matched to the purchase order and the receipt before anything is paid. Mismatches get held, not paid and argued about later. This closes the procure-to-pay process, and if the difference between the two documents is unclear, see purchase order vs invoice.
  7. Supplier performance review. On-time-in-full, defect rates in parts per million, responsiveness on expedites. Reviewed on a cadence, not only after something goes wrong.

Taken end to end, that is the procurement lifecycle applied to a factory. For the generic version with more depth on each stage, read our full procurement process guide.

Why Procurement Decides Whether a Plant Makes Money

For most manufacturers, purchased materials are the single largest line in the cost of goods sold. That has three consequences worth spelling out.

  • Price moves straight to margin. A percentage point off material cost lands on the bottom line far faster than the same percentage squeezed out of labour.
  • Late material costs more than the part. A missing component idles operators, burns overtime later, triggers expedite freight and sometimes a late-delivery penalty. The part was cheap. The shortage was not.
  • Supplier quality becomes your quality. A bad batch that clears incoming inspection ends up in a customer’s hands with your name on it.

This is also why procurement and supply chain are related but not the same thing — the comparison in procurement vs supply chain management is worth reading if you are defining team boundaries.

Where Manufacturing Procurement Usually Breaks Down

These are the failures that show up again and again on plant floors, in roughly the order they cost the most:

  • Lead time volatility. A quoted one-week delivery becomes a month when a shipping lane snarls up, and the whole production calendar shifts with it.
  • Inventory at both extremes. Over-order and you have cash sitting in a rack. Under-order and the line stops. Most plants manage to do both at once, on different part numbers.
  • Manual paperwork. Wet signatures, spreadsheet order logs and approvals living in someone’s inbox. Orders get lost, duplicate POs get raised, and nobody can answer where a request currently sits.
  • Hidden and maverick spend. Maintenance buys direct from a local supplier because it is faster. Multiply that across departments and you lose both the audit trail and the volume discount.
  • Compliance and traceability pressure. Certificates of conformity, material traceability, ethical sourcing declarations, ISO audit evidence. If that lives in scattered folders, audit week becomes a fire drill.
  • Fragmented supplier data. Contacts in one place, contracts in another, performance history in someone’s memory. Decisions get made on the last conversation rather than the record.

A wider view of these issues sits in our guide to procurement challenges, with the regulatory side covered in procurement compliance and the supply-side exposure in procurement risk management.

A Quick Self-Check Before You Change Anything

Four questions, honestly answered, will tell you where to start:

  • Are POs and invoices still being handled by hand, or matched manually?
  • Can you pull up a supplier’s on-time delivery record for the last six months without asking anyone?
  • Do you know your true stock position right now, or the position as of the last count?
  • If a request was raised on Monday, can you say where it is on Wednesday?

If any answer is no, that is your first step — not the shiniest module on a software demo.



Quote icon

Procurement workflows that take the conventional route are 26% more likely to encounter complexity in their procurement transformation.

Gartner, Simplify Your Complex Procurement Workflow



How to Streamline Procurement in Manufacturing: 7 Steps

None of these steps needs a two-year programme. Done in order, each one makes the next easier.

Step 1: Map the Process You Actually Have

Not the one in the SOP folder. Follow three real requests from the moment someone asked for something to the moment the supplier was paid, and write down every handoff, every approval and every wait. Put rough hours against each stage.

The result is usually uncomfortable and very useful: most of the cycle time turns out to be waiting, not working. That map becomes the baseline you measure improvement against, and it feeds directly into a workable procurement plan.

Step 2: Put Every Request Through One Front Door

Requests arriving by email, WhatsApp, corridor conversation and paper form cannot be managed, only chased. One intake point, one form, one queue. Everything raised, approved and ordered in the same place.

This is the core argument for a centralized procurement system: not control for its own sake, but a single record of what was asked for, who approved it and when. Approval limits by value, by category and by site can then be enforced automatically instead of remembered.

Step 3: Standardise What People Are Allowed to Buy

Buyers waste an extraordinary amount of time re-sourcing things the company already has a contract for. Publish approved items and approved suppliers so that ordering gloves or a bearing is a two-click job with a pre-negotiated price behind it.

Well-maintained catalog management in procurement removes most of the low-value work from indirect spend, and consistent policy across departments is the foundation of every list of procurement best practices worth following.

Step 4: Automate the Repetitive Work

Anything that follows a fixed rule should not be occupying a person. In most plants that means:

  • Raising POs automatically when stock hits a reorder point
  • Routing approvals by value and category, with reminders when they stall
  • Sending order confirmations and delivery chasers to suppliers
  • Reading supplier invoices and matching them to the PO and the receipt

An automated purchase order system handles the first of those on its own. For the wider picture, our procurement automation guide covers what to automate first, and AI in procurement explains where document reading and exception handling are now doing genuine work rather than demo-ware.

Step 5: Connect Procurement to Inventory, ERP and Finance

Siloed systems are why the same number exists in three places and disagrees with itself. When procurement, stock and the general ledger share one source of truth, a receipt updates stock and accrues the cost in the same movement, and nobody re-keys anything.

For a plant, the purchase order and inventory management link is the one that pays for itself first — reorder points only work if they are reading live stock. Beyond that, integrating procurement with ERP and financial systems gives finance visibility on committed spend before the invoice arrives, which is exactly what procurement and finance alignment depends on. The practical options are covered in procurement integration.

Step 6: Manage Key Suppliers Like Partners, Not Price Lists

On a shortage, the supplier who moves you up the queue is the one who knows your schedule and trusts your forecast. That relationship is built long before you need it.

  • Talk on a cadence. A short monthly call on forecast, capacity and quality prevents most escalations.
  • Share forward demand. Suppliers who see your schedule can hold material for you. Suppliers who see only POs cannot.
  • Contract for the long run on critical parts. Volume commitments buy price stability and priority allocation — the mechanics are in our procurement contract guide.
  • Score performance on facts. On-time-in-full, defect PPM, response time on expedites. Reviewed quarterly, shared with the supplier.
  • Solve problems jointly. When something goes wrong, a root-cause session beats a penalty letter. Structured procurement collaboration tends to produce the better outcome for both sides.

Step 7: Track a Few Numbers and Actually Act on Them

You do not need a dashboard with forty tiles. You need five numbers reviewed on a rhythm:

  • Lead time by part and supplier — quoted versus actual, so planning uses real figures.
  • On-time-in-full delivery — the clearest single measure of supplier reliability.
  • Purchase price variance — what you paid against the standard or contracted price.
  • Inventory turns — low turns mean cash parked in a rack; spiking turns often precede a stockout.
  • Requisition-to-order cycle time — the internal delay you fully control.

Definitions and benchmarks for these sit in our procurement KPIs guide. To find where the money is going in the first place, run a proper spend analysis — it is usually the fastest route to identifying real procurement savings. Regular procurement reporting keeps those findings in front of the people who can act on them, and procurement analytics turns the history into forecasting you can plan against.

Choosing Procurement Software That Survives a Factory Floor

Plant requirements are not office requirements. When you shortlist, weight these heavily:

  • Live two-way sync with inventory and your ERP, not a nightly file export
  • Mobile approvals, because supervisors are not sitting at a desk
  • Multi-site support with per-site budgets, catalogues and approval limits
  • Invoice capture and three-way matching built in, not bolted on
  • Document storage against the supplier record for certificates, contracts and audit evidence
  • Reporting a plant manager can read without a data analyst

Our comparison of the best procurement software and the overview of types of procurement tools are the fastest way to build a shortlist, and e-procurement software covers what the category includes. If you would rather see it running than read about it, book a procurement software demo and ask them to show a PO raised from a low-stock trigger, end to end.

If You Only Have 90 Days

A realistic sequence for a plant that is starting from spreadsheets and email:

Days 1–30: Map the current process, pull twelve months of spend into one file, and identify your top twenty suppliers by value and your top twenty by order count. Those two lists rarely overlap, and both need fixing for different reasons.

Days 31–60: Move requests and approvals into one system. Set approval limits. Load your repeat indirect items into a catalogue so routine buying stops touching a buyer.

Days 61–90: Connect stock levels to reordering, switch on invoice matching, and start the monthly supplier review with the five metrics above. Measure your cycle time against the baseline from day one.

From there, a longer-range procurement strategy gives the work direction beyond the first quarter.

Final Thoughts: Procurement Is a Production Decision

Manufacturing procurement stopped being a back-office task some time ago. Every buying decision is a production decision in advance — it sets what the line can build, when it can build it, and what the margin will be when it ships.

Streamlining it is not really a technology project. It is a matter of seeing the process honestly, removing the waiting, standardising the routine, and putting real numbers behind supplier conversations. The software matters because it makes those things stick.

Zapro brings requisitions, purchase orders, inventory levels, supplier records and invoice matching onto one platform, so a shortage shows up before it becomes downtime. See pricing and plans for the tiers that include inventory management, or talk to our team about your plant’s setup.

FAQ

1. What is the procurement process in manufacturing?

It runs in a cycle: planning requirements from the bill of materials and production schedule, selecting a supplier, raising and approving a requisition, issuing a purchase order, receiving and inspecting the goods, matching the invoice against the PO and the receipt, and paying. Supplier performance review then feeds back into the next sourcing decision.

2. What are the types of procurement in manufacturing?

The two main types are direct procurement — raw materials and components that physically go into the finished product — and indirect procurement, which covers everything that keeps the plant running: tooling, maintenance supplies, safety equipment, freight and services. Some manufacturers separate out services procurement as a third category because it is contracted differently.

3. Can you give examples of procurement in manufacturing?

A vehicle manufacturer buying steel, rubber and wiring harnesses is direct procurement. The same manufacturer buying press lubricant, safety vests, replacement cutting tools or a calibration contract is indirect procurement. Both come out of the same budget, but they are planned, sourced and controlled in very different ways.

4. Why is procurement important in manufacturing?

Because it drives both the cost of the product and the reliability of the schedule. Purchased materials are usually the largest component of cost of goods sold, so price and terms move straight to margin. And since production cannot start without every component present, a single late delivery can idle a line that costs far more per hour than the part itself.

5. What are the common challenges in manufacturing procurement?

The recurring ones are unpredictable supplier lead times, inventory swinging between overstock and stockout, manual purchase orders and invoicing, weak visibility into what departments are actually spending, scattered supplier data, and the effort of proving compliance and material traceability during audits.

6. What are the benefits of strategic sourcing in manufacturing procurement?

Strategic sourcing looks past the lowest quoted price to total cost of ownership — quality, freight, tooling, capacity, risk and the supplier’s ability to grow with you. Manufacturers that source this way typically see fewer disruptions, steadier quality, better contract terms and stronger negotiating positions, because decisions are made on performance data rather than on the most recent quote.

7. How does technology improve manufacturing procurement processes?

It removes the delays and the re-keying. Approvals route automatically and can be signed off from a phone. Purchase orders are raised from live stock levels rather than a manual check. Invoices are read and matched against orders and receipts. Supplier certifications, contracts and performance history live in one searchable record, and spend reporting is available without building a spreadsheet first.

8. What role does real-time spend visibility play in manufacturing procurement?

It lets managers see committed spend against budget as it happens rather than at month end. That means price increases get spotted while there is still time to challenge them, duplicate orders across sites become obvious, volume can be consolidated for better rates, and budget overruns are prevented instead of explained afterwards.
